The current official STR Cribs offering covers short-term rental design, renovation, furnishing, installation, and amenity work. This STR Cribs review provides a framework for evaluating a property-specific proposal.
STR Cribs Service Scope
If a STR Cribs proposal combines multiple project phases, the signed agreement should identify each included phase and the party responsible for every task. Owners should classify every line item as design, construction, products, logistics, fieldwork, financing, or closeout so overlapping services are counted once.
| Service area | What must the proposal define? | What record confirms completion? |
|---|---|---|
| Design | The proposal must identify contracted rooms, measured plans, concepts, product specifications, revision limits, and approval dates. | The owner retains the approved plans and product schedule. |
| Renovation | Identify drawings, trades, budget allowances, permits, inspections, change orders, and warranty responsibilities. A budget allowance is a placeholder amount that changes when the selected quantity or unit price changes. | Retain signed inspections, a completed list of corrected defects, and warranty documents. |
| Furnishing | Identify products, quantities, procurement, freight, receiving, storage, assembly, placement, and styling. | The owner retains the final room inventory, invoices, and installation checklist. |
| Amenities | Identify design, site work, utilities, equipment, barriers, testing, operating requirements, and maintenance. | The owner retains permits, testing records, manuals, and the maintenance plan. |
STR Cribs Design Deliverables
The design scope turns property goals into instructions that purchasing and field teams can execute. A complete package identifies room dimensions, guest capacities, walking paths, built-in or immovable property features, finishes, lighting, furniture footprints, quantities, and acceptable substitutions. Every drawing and schedule needs a version number and approval date.
Use a responsibility matrix to evaluate a design proposal, including work performed on site or remotely. Name the party that measures, purchases, receives, installs, corrects differences between approved documents and actual site conditions, and approves substitutions. The resulting assignments define the execution scope.
A Fulhaus furnishing proposal can be evaluated with the same responsibility matrix: assign purchasing, receiving, assembly, placement, and final acceptance separately for every room.
| Design record | What information must it contain? | What decision does it control? |
|---|---|---|
| Property brief | Record the address, verified measurements, existing conditions, guest capacities, budget, target date, and access limits. | The brief establishes the requirements used to price and design the project. |
| Room plan | Record furniture footprints, placement dimensions, circulation paths, lighting, storage, and functional zones. | The plan controls whether specified products fit and support the approved room capacity. |
| Product schedule | Record brand, model, dimensions, finish, quantity, unit price, lead time, warranty, and substitution criteria. | The schedule controls purchasing, receiving, installation, and replacement records. |
| Approval log | Record each approved drawing, product, revision, substitution, cost change, and schedule effect. | The log establishes the authorized project baseline. |
STR Cribs Renovation Responsibilities
A renovation proposal needs a trade-by-trade scope. It should name the contracting party, responsible trade contractor, permit applicant, inspection responsibility, material allowance, payment milestone, change-order process, cleanup duty, warranty, and closeout record for each work category. An Airbnb construction plan connects those assignments to site feasibility, rental permission, construction approvals, and occupancy closeout.
The schedule should separate design, engineering, permit review, procurement, demolition, framing, utility, and other concealed construction work, inspections, finishes, furnishing, cleaning, and photography. Product lead times and government review periods need their own assumptions because they can affect the launch date independently from field labor duration.
A written change order records the added or removed work, price adjustment, schedule effect, and approval before execution. This record makes original scope, substitutions, and newly requested work easier to reconcile against later invoices.
STR Cribs Furnishing and Safety
The furnishing scope connects the approved room plan to procurement and installation. It must assign the party that legally purchases each product and holds the related invoice and warranty rights, purchasing accounts, freight, receiving, storage, damage claims, assembly, placement, anchoring, testing, packaging removal, styling, and final inventory.
For U.S. properties, the U.S. Consumer Product Safety Commission recommends anchoring televisions and top-heavy furniture, placing televisions on sturdy bases intended for them, and keeping items that attract children away from furniture tops. The installer follows product instructions and applicable building requirements and records completion. The agency publishes supporting furniture and television tip-over guidance.

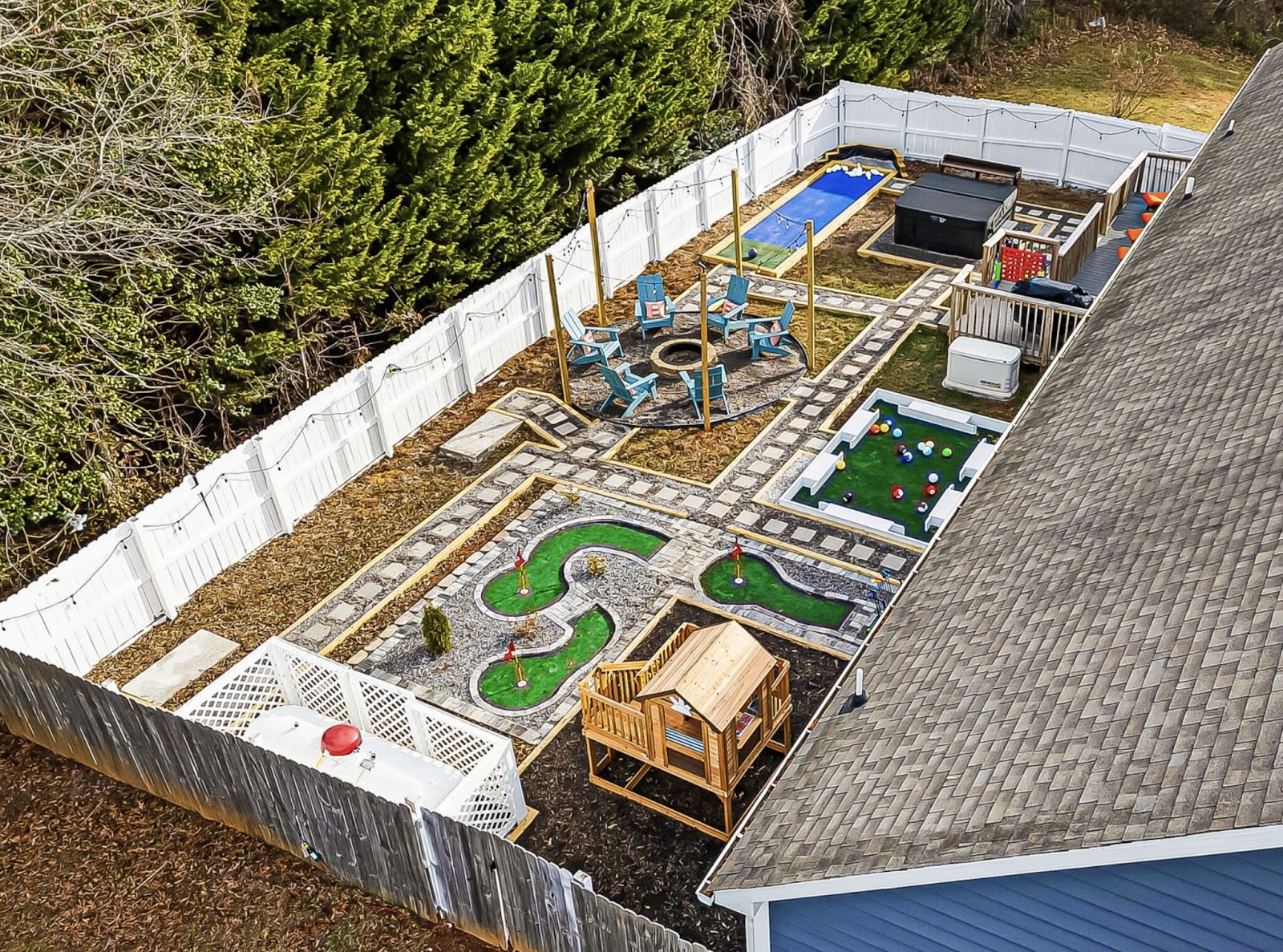

STR Cribs Amenity Evaluation
An amenity decision requires a complete installed cost and an operating plan. The project budget includes design, site preparation, equipment, freight, utility work, permits, installation, barriers, drainage, lighting, signage, insurance requirements, cleaning, maintenance, consumables, repair reserves, and expected downtime.
Incremental cash flow equals added annual revenue minus added annual operating costs. Simple payback equals installed cost divided by annual incremental cash flow. Worked example: Assume an amenity costs $24,000 to design and install. A simplified planning assumption uses $9,000 in added annual revenue and $3,000 in added annual operating costs. Incremental cash flow is $6,000, so simple payback is $24,000 ÷ $6,000 = 4 years. This illustration excludes financing, taxes, time value of money, demand variability, replacements, and resale value. A property forecast must replace the assumed revenue with documented occupancy, nightly-rate, downtime, and maintenance inputs.
The operating plan assigns inspection frequency, shutdown conditions, cleaning, guest instructions, vendor response, replacement parts, and incident records. These duties remain necessary after installation and belong in the investment decision.
STR Cribs Project Cost
Total project cost is the amount required to complete the contracted scope and place approved products and amenities into service. Professional fees cover design service costs and project administration. Product costs cover approved quantities at quoted unit prices. A product markup is an amount or percentage added above the underlying product price; the proposal must disclose its basis, and the quoted product cost must include it so the formula counts it once. Construction costs cover contracted trade work. Logistics costs cover freight, receiving, storage, delivery, and access. Fieldwork costs cover assembly, installation, anchoring, testing, styling, and debris removal. Taxes, permits, and travel use their quoted amounts. Documented credits exclude discounts already reflected in product costs.
Calculate total project cost as: professional fees + product costs + construction costs + logistics costs + fieldwork costs + taxes + permits + travel costs − documented credits. Calculate contingency separately for identified uncertainty, then add it to total project cost to create the comparison budget. The comparison budget is the planning total used across proposals; the contingency is an allowance and may remain unspent. Financing costs remain separate so a cash proposal and a financed proposal use the same underlying project scope.
Worked example: Assume $5,000 in professional fees, $30,000 in products, $18,000 in construction, $4,000 in logistics, $7,000 in fieldwork, $3,000 in taxes and permits, and a $2,000 credit. Total project cost is $65,000. A separate $6,500 contingency produces a $71,500 comparison budget. Products account for $30,000 of the $65,000 total project cost; all remaining listed costs, net of the $2,000 credit, account for $35,000. The illustration excludes financing costs and any category absent from the assumptions.
STR Cribs Financing Review
Use the executed lender documents to evaluate financing. The borrower records the amount financed, annual percentage rate, fees, payment frequency, term, promotional conditions, prepayment terms, collateral or another lender claim securing repayment, default provisions, and total repayment. The documents must also identify the eligible borrower and permitted use of proceeds.
Worked example: Assume $40,000 is the net loan proceeds available for project costs and the lender states $4,000 in finance charges. Stated repayment is $44,000 when the finance charges are the only added cost. A $71,500 comparison budget leaves a $31,500 funding gap. Loan-cost comparison requires the term, annual percentage rate, payment schedule, and fee treatment in addition to this simplified funding illustration. It distinguishes available loan proceeds from the complete project budget.
STR Cribs Workflow and Closeout
- Define the property brief, occupancy limit established by the applicable permit or local rule, target guests, room functions, launch date, and comparison budget.
- Record existing conditions with verified measurements, photographs, systems, defects, and access constraints.
- Approve the design documents, product schedule, construction scope, allowances, responsibilities, and exclusions.
- Convert the approved scope into procurement and construction schedules that identify approval deadlines and predecessor tasks that must finish before later work can begin.
- Authorize every change through a written cost and schedule record before execution.
- Inspect construction, deliveries, installation, safety work, testing, and inventory against the approved documents.
- Close incomplete, damaged, or defective items and collect final accounting, permits, warranties, manuals, and inventory.
Final acceptance requires the completed property to match the approved scope. The closeout file contains the signed agreement, approvals, change orders, invoices, inspection records, warranties, care instructions, equipment manuals, model numbers, final photographs, room inventory, and completed correction list.
STR Cribs Review Criteria
Owner references should document project delivery and match the proposed service type, market, budget, and completion period. Useful records include original and final budgets, approved changes, scheduled and actual completion dates, product damage resolution, correction completion, and warranty response.
A fair STR Cribs review separates provider-controlled work from market conditions and owner decisions. Before attributing an outcome, identify which party controlled scope, approvals, purchasing, access, permitting, contractors, launch timing, rates, and operations.
STR Cribs Contract Requirements
The agreement should name the legal contracting entity, project contacts, property, rooms, drawings, construction work, products, revisions, procurement, markups, allowances, exclusions, access procedure, payment milestones, schedule, change orders, insurance, permits, inspections, damage claims, substitutions, cancellation, termination, warranties, closeout, and final acceptance.
The proposal becomes comparable when every included task has a price, responsible party, completion record, and acceptance standard. Reject a proposal when any material task lacks a price, responsible party, completion deadline, or acceptance record.
